PROJECT PROGRESS

Currently, around 94% of the about 230 kilometre long tunnel system has been excavated.

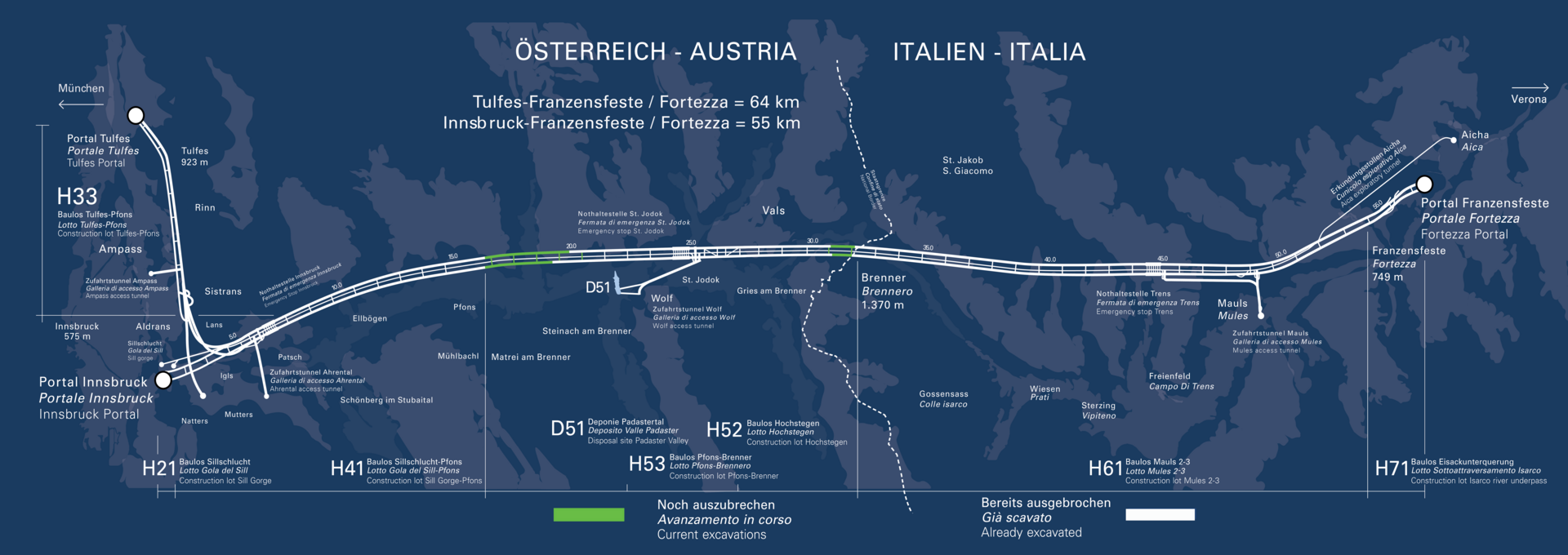

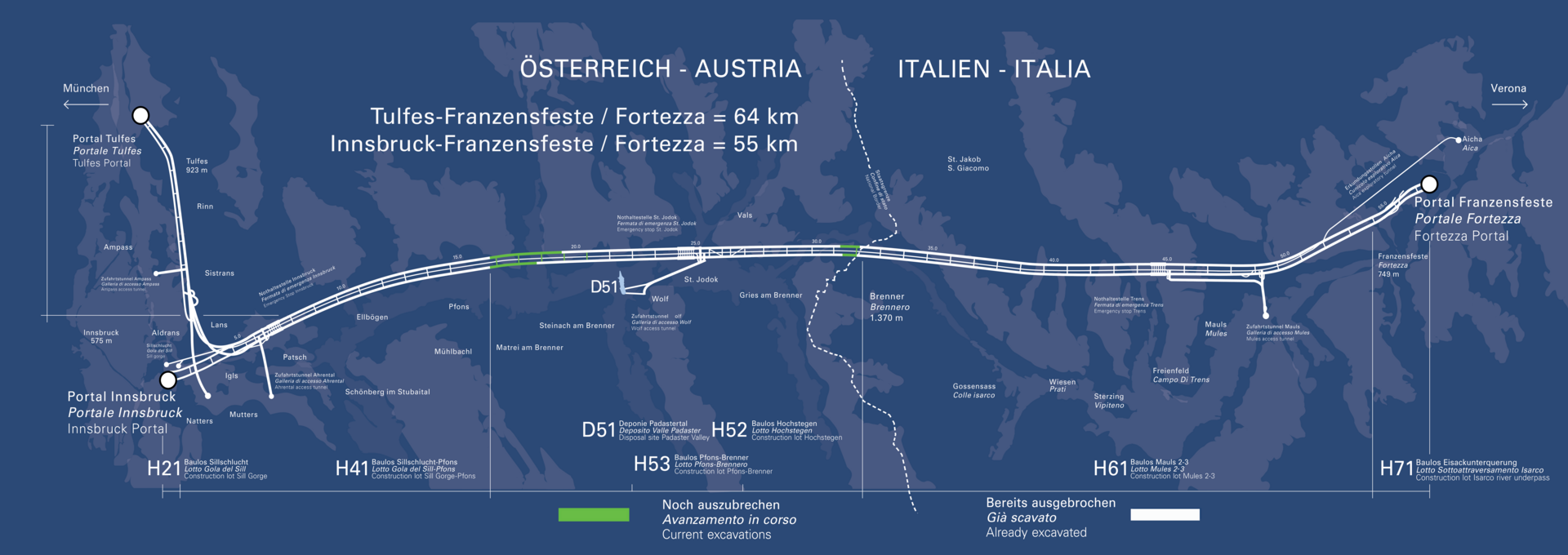

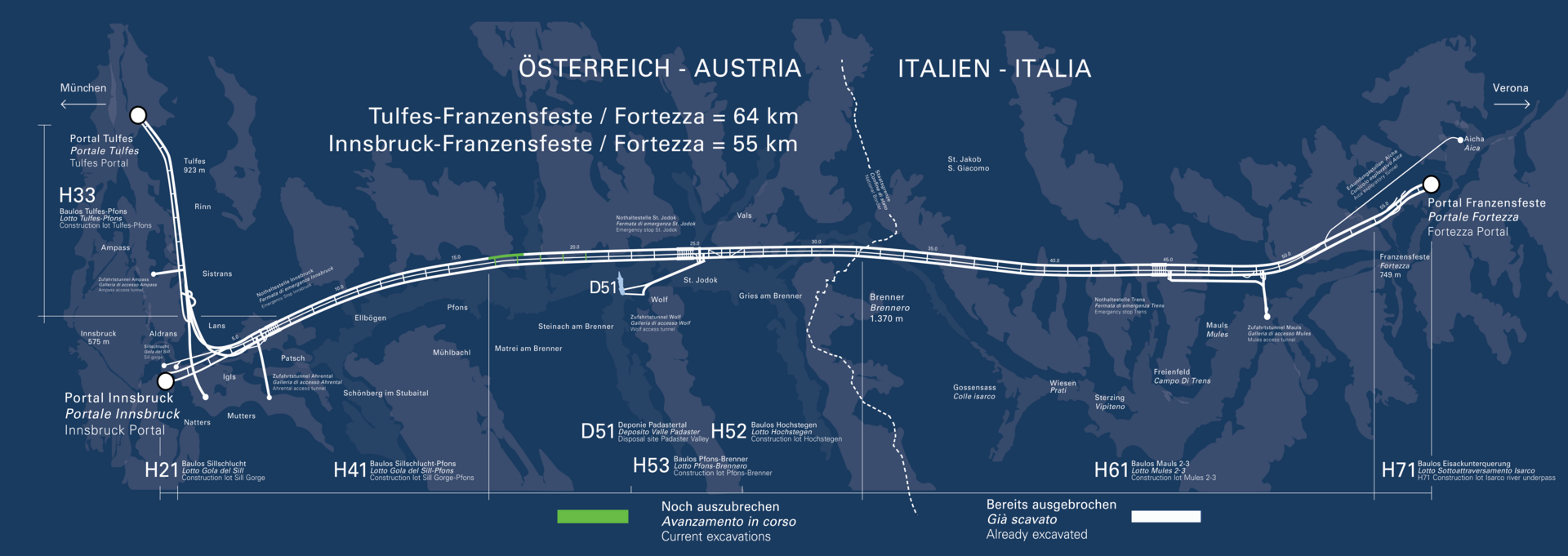

In order to construct the complex tunnel system efficiently, the BBT project has been divided into several construction sections, so-called construction lots. This makes it possible to proceed with multiple excavation methods simultaneously in different locations along the new line.

OVERALL PROJECT PROGRESS

216 km
Tunnel Icon
230 km

Of the total of approximately 230 kilometres of tunnel to be built, 216 kilometres have been excavated for the BBT tunnel system to date.

KILOMETRES
110

OF RAILWAY TUNNEL

KILOMETRES
57

OF EXPLORATION TUNNEL or SERVICE TUNNEL

KILOMETRES
49

ACCESS TUNNEL, RESCUE TUNNEL AND LOGISTICS TUNNEL

KILOMETRES
216

OF WHICH HAVE BEEN EXCAVATED TO DATE

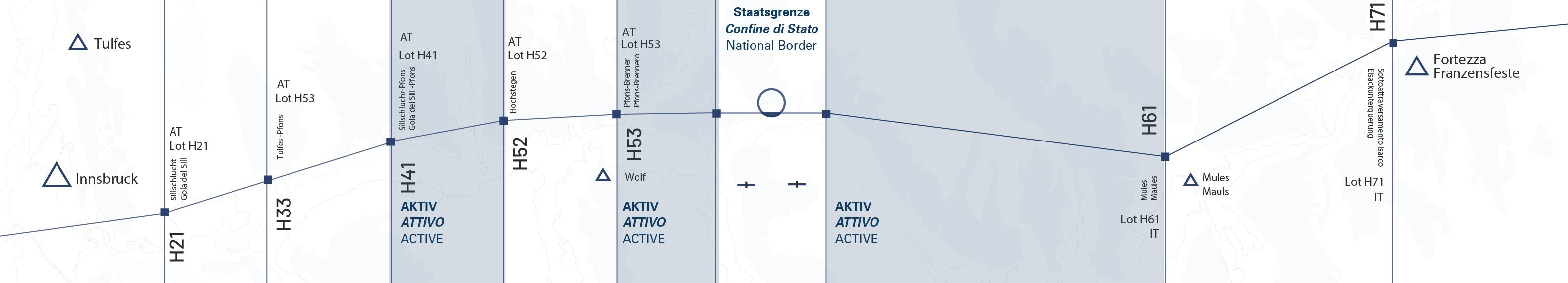

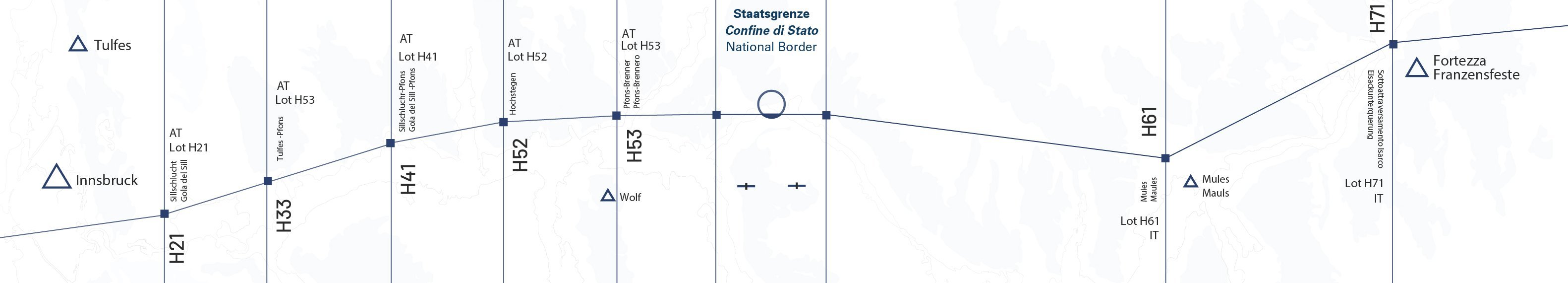

There are currently three active construction lots, one of which is located in Italy and two in Austria.

BRENNER BASE TUNNEL - A PROJECT UNITING EUROPE   BRENNER BASE TUNNEL   A PROJECT UNITING EUROPE - BRENNER BASE TUNNEL
